Haughton Solar Farm in Queensland, Australia - Project details and construction updates

Last Modified: Fri Jun 05 2020 04:04:45 GMT+0530 (India Standard Time)
  • 500 MW
    generation capacity of the Haughton Solar Farm located in North Queensland’s Burdekin Shire (40km west of Ayr and 60km south of Townsville. The farm will be built over three stages in the next eight years. 100 MW, Stage 1 is operational as on 30 Oct 2019.
  • ? MWh
    of electricity will be generated each year.
  • 170,000
    Approximate number of households that will receive clean and renewable energy once the project is operational. Phase I is expected to power around 50,000 homes.
  • ? tonnes
    estimated reduction in CO2 emissions each year.
  • 1,181 hectares
    of land available for the farm.
  • 1,000,000
    solar PV modules are likely to be used. Over 400,000 panels are estimated to be used in Phase 1.
  • 3
    major organisations involved: Project Developer: Pacific Hydro, EPC & O&M: RCR Tomlinson, Distribution: Powerlink
  • $? million
    estimated project cost.
  • 240
    jobs will be created during the construction phase.
  • ?
    FTE jobs will be created once the park is commissioned.
  • 2018
    expected start of construction in 1Q2018
  • 14 Jun 2017
    planning consent received from the Burdekin Shire Council. Mayor Lyn McLaughlin said the approval was subject to Pacific Hydro meeting specific conditions, including upgrading part of the road used to access the site.
  • 17 May 2018
    Connection agreement signed with state owned transmission company Powerlink.
  • May 2018
    RCR Tomlinson awarded full EPC/O&M contract. RCR’s EPC and O&M contracts for this project are valued at approximately $175 million.
  • 01 Aug 2018
    Generation authority application submitted to the Department of Natural Resources, Mines and Energy, Queensland.
  • 23 Oct 2018
    Pacific Hydro reaches financial close on $115M of non-recourse project financing the project. Finance will be provided by the Industrial and Commercial Bank of China Limited, National Australia Bank Limited and Westpac Banking Corporation.
  • 14 May 2019
    Pacific Hydro announces the final solar panels have been installed for Phase I.
  • 29 May 2019

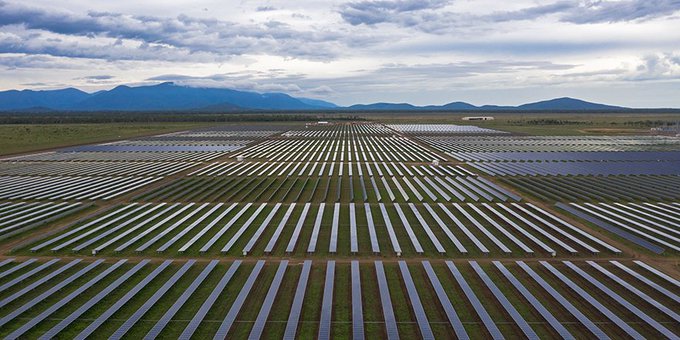

    Stage 1 connects to the grid and now operational.
  • 01 Sep 2019
    Pacific Hydro opens a community grant program - the Haughton Sustainable Communities Fund. This fund will deliver a portion of revenue from the project back into the local community each year, for the life of the solar farm. Each year, eligible community groups and not-for-profit organisations are can apply for project funding up to $10,000 from a pool of $50,000.
  • 15 Oct 2019
    An innovative network support agreement is signed between Stanwell Corporation Limited (Stanwell) and Pacific Hydro under which the former will provide the latter with the necessary network support to manage the operational obligations it faces to get up and running.
  • 30 Oct 2019
    Pacific Hydro celebrates official opening of Haughton Solar Farm.
