Merredin Solar Farm, Western Australia, Australia

Last Modified: Thu Jan 16 2020 08:08:11 GMT+0530 (India Standard Time)
  • 132 MW
    planned installed capacity of the Merredin Solar Farm, located about 5 kilometres south south-west of Merredin, half way between Perth and Kalgoorlie in Western Australia's central Wheatbelt.
  • 281 GWh
    of electricity will be generated per year.
  • 42,000
    approximate number of households that can be powered by the farm each year.
  • ? tonnes
    estimated reduction in CO2 emissions each year, once the farm is operational.
  • 460
    hectares of leased rural land which is relatively flat and receives strong consistent solar irradiance, making it an ideal location. The site has been selected due to its proximity to the Merredin Terminal Substation with relatively minor works required to connect the solar farm to the South West Interconnector System.
  • 360,000
    Number of Risen Energy 370W high performance monocrystalline PERC module panels that will be mounted on a single axis tracking system. 22 Inverter stations will convert the power from the solar panels to alternating current (AC) before entering an onsite substation.
  • 3
    major organisations involved: Project Developer: Risen Energy, Stellata Energy and UK based Ingenious, EPC and O&M: Risen Energy (Australia), Monford Group, Pilecom, Distributor: Western Power
  • $200 million
    estimated project cost.
  • 200
    peak jobs during construction phase.
  • 5
    FTE during operational phase.
  • 1H 2018
    Expected start of construction with completion in early 2019..
  • 29 Jun 2017
    Farm secures planning permission.
  • 11 Oct 2018
    Leading Chinese solar module supplier, Risen Energy buys the project. to begin construction this year. John Zhong, the head of project development and investment director for Risen Energy Australia, says construction is expected to begin before the end of the year and be completed 12 months later.
  • 15 Mar 2019
    Ground breaking ceremony conducted to commemorate the start of construction of the project. Honourable Mia Davies, MLA, Member for Central Wheatbelt, Cr Ken Hooper, President, Shire of Merredin and Eric Lee, General Manager Risen Energy (Australia) are key attendees.

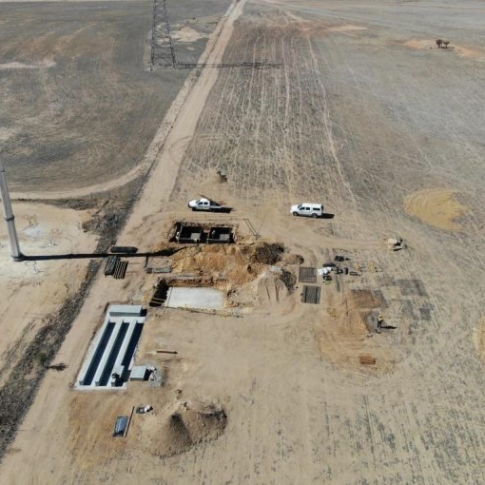

  • Jul 2019
    Bulk earthworks to prepare the site for installation of the solar panels and substation equipment are under way. The substation installation is progressing with equipment foundations being poured, the installation of the control room and erection of the gantry. High voltage wires to connect the substation to Western Power’s Merredin Terminus have been strung and to be energised once the substation and farm are substantially complete.

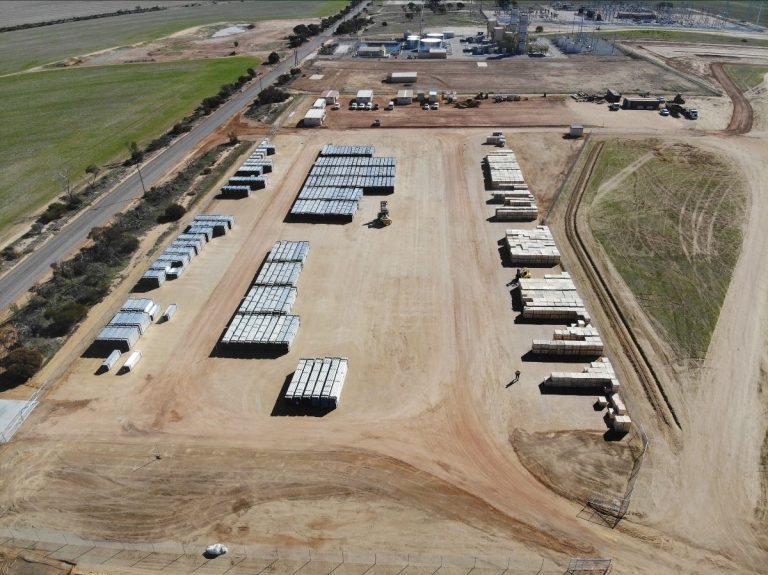

  • Oct 2019
    Monford Group plans to install the panels, torque tubes, trackers inverters and build the new substation. High voltage conductors to connect the substation to Western Power’s Merredin Terminus have been strung and will be energised once the substation and solar farm are substantially complete.
  • 08 Nov 2019
    Pilecom installs the last of the 46,563 steel post foundations. The tracking system and solar panels are mounted on these piles.
  • Dec 2019
    The project's civil and mechanical works are completed by the principal construction contractor, Monford Group. 354,452 PV panels and 4,249 torque tubes were installed, with approximately 60 km of cable trenching laid and 22 inverters placed onto their foundations. On-site labour peaked at 425 staff and the speed at which they completed the works was exceptional.
