Mortlake South Wind Farm, Victoria, Australia - Project details and construction updates

Last Modified: Fri Apr 24 2020 05:38:37 GMT+0530 (India Standard Time)
  • 157.5 MW
    planned installed capacity of the Mortlake South Wind located approximately 5 km south of the Mortlake township, within the Moyne Shire. The project is 1 of 6 developments within the state to be awarded a supply agreement through the Victorian Renewable Energy Auction Scheme.
  • 530 GWh
    proposed to be generated per year.
  • 115,000
    approximate number of households that can be powered by the farm each year.
  • 532,000 tonne
    estimated reduction in CO2 emissions each year, once the farm is operational.
  • 6,003 hectares
    Land that has been leased of which less than 1% will be disturbed for use. The wind farm will be constructed on cleared, level land which is predominately dairy farming country. The location has been selected for its high exposure to consistent winds across this part of the state and close proximity to the transmission network.
  • 35
    Number of N149/4.0-4.5 Nordex (4.5MW each) turbines with a maximum tip height of 186 metres that will be used. The project will incorporate an energy storage installation with the aim of improving its performance and facilitating its grid integration.
  • 3
    major organisations involved: 1) Project owner and developer: Acciona 2) EPC & O&M: TBD 3) Power distribution: TBD
  • $275 million
    estimated project cost.
  • 124
    approximate jobs that will be generate during construction - 90 new and 34 retained jobs. In the photo is Stephan, a Terang local and a new member of the John Beever team hired through a partnership with Connect Jobs Australia.
  • 10
    FTE during operational phase.
  • Apr 2017
    The Minister for Planning approved an amendment to the planning permit to allow for the use of contemporary wind turbine technology. Planning approval was originally granted by the State government in 2010.
  • $20,000
    Size of a Small Grants Program – Each year this amount will be made available for community events, projects and activities. Community organisations and groups can apply for small grants through an application process. Advertisements will be placed in local media to promote the program and request applications.
  • 2019
    planned start of construction. The project is expected to be completed in early 2020.
  • 08 Mar 2019
    Sod-turning event held on site, which was attended by the Hon Lily D'Ambrosio MP, Victoria’s Minister for Energy, Environment and Climate Change. ACCIONA has announced its intention to build an underground transmission line for its new Mortlake South Wind Farm, demonstrating its commitment to working closely with communities to deliver tailored local solutions.
  • 24 Apr 2019
    Nordex secures turbine order from Acciona Energy Australia.
  • 04 Jul 2019

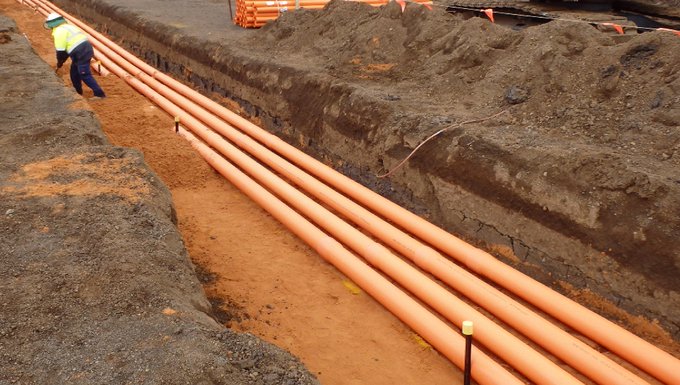

    John Beever Australia (JBA) awarded the D&C contract for the 220KV underground transmission cable. JBA was earlier awarded the contract to complete the civil works package for the project including all roads and hardstands.
  • 18 Sep 2019

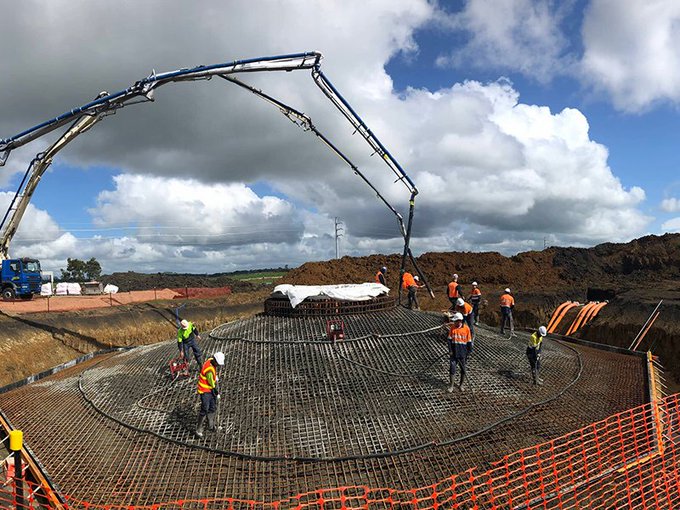

    4th foundation pour completed by JBA.

  • 30 Jan 2020
    Last of the 35 concrete base pours completed by JBA.
  • 13 Feb 2020
    Wilson Transformers completes it delivery of transformer to site valued at around $2 million.
  • 10 Mar 2020
    Construction of the 220kV underground connection line to connect the site to the National Electricity Grid via the Terang Terminal Station starts.
